The common mistake with incomplete drawings is trying to make the quote look complete before the information is complete. That may feel cleaner for the client, but it leaves the builder carrying assumptions that should have been visible. A better fixed-price workflow is to build a structured first pass, then decide what belongs in the client quote and what needs a qualification, PC sum, provisional allowance or exclusion.

Why incomplete drawings create margin risk

A drawing pack can look substantial while still missing the details that move the price: drainage routes, structural steel, specification levels, finishes, access, temporary works, utility moves, making good, fire requirements, insulation build-ups, roof details or final client selections. If those items are priced from memory or absorbed into a round total, the quote may look confident while the commercial basis is actually weak.

The point is not to wait for perfect information. Many builders need to respond quickly. The point is to stop treating all numbers as equally certain.

A practical pricing method

  1. List the documents you have. Drawings, specifications, engineer notes, photos, emails, site notes and existing quote files should be treated as separate evidence, not one blended pack.
  2. Extract the visible scope. Pull out the work packages that are clearly shown: demolition, groundworks, drainage, structure, roof, windows, doors, electrics, plumbing, finishes, external works and preliminaries.
  3. Mark missing information early. Do this before adding margin. Missing items are easier to reason about while the quote is still in package form.
  4. Price reasonable assumptions. Use explicit assumptions where a first-pass number is needed, such as assumed access, assumed roof system, allowance for unknown drainage or provisional steel pending engineer pack.
  5. Separate PC sums and provisional areas. Do not let them disappear into the total. They should be visible before the builder decides what to present.
  6. Review margin and contingency after uncertainty is visible. Margin is not a substitute for missing scope. Contingency should be connected to named risks, not just a blanket percentage.
Rule of thumb

If you cannot explain why a number is in the quote, it should not be hidden inside the total. It should be clarified, qualified, separated or excluded.

What to separate in the quote pack

Part of the quote What it means How to handle it
Known scope Items clearly visible in the drawings, spec or notes. Price normally by labour, materials, plant, subcontractors and prelims.
Priced assumption A reasonable allowance based on incomplete but directionally clear information. Show the assumption and decide whether it appears in the client quote.
Provisional area Work likely required but not defined enough for a reliable fixed number. Separate it, state the basis and flag what information will firm it up.
PC sum A client selection or supply item that depends on final choice. Keep it separate from labour, installation, prelims, margin and contingency.
Exclusion Work not priced because it is not shown, not requested or not sufficiently defined. State it clearly before the client assumes it is included.

Example: incomplete extension drawings

A single-storey extension pack may show the footprint, basic layout and external form, but still leave structural steel, drainage route, roof system, finishes and electrical specification unresolved. A rough total can be sent quickly, but it gives the builder very little protection. A structured first-pass quote would split the work into packages and mark uncertainty inside each one.

Example wording for internal review

Groundworks priced on assumed machine access and standard spoil route. Drainage alteration allowance included pending survey. Structural steel provisional until engineer schedule lands. Electrical allowance based on first and second fix to standard room layout, final point schedule excluded.

Before sending the fixed-price quote

  • Check that each work package has a pricing basis.
  • Check that every assumption is either accepted, qualified or excluded.
  • Check that PC sums and provisional areas are not blended into the final price.
  • Check whether contingency is attached to named risk.
  • Check whether the client-ready quote hides anything the builder still needs to decide.

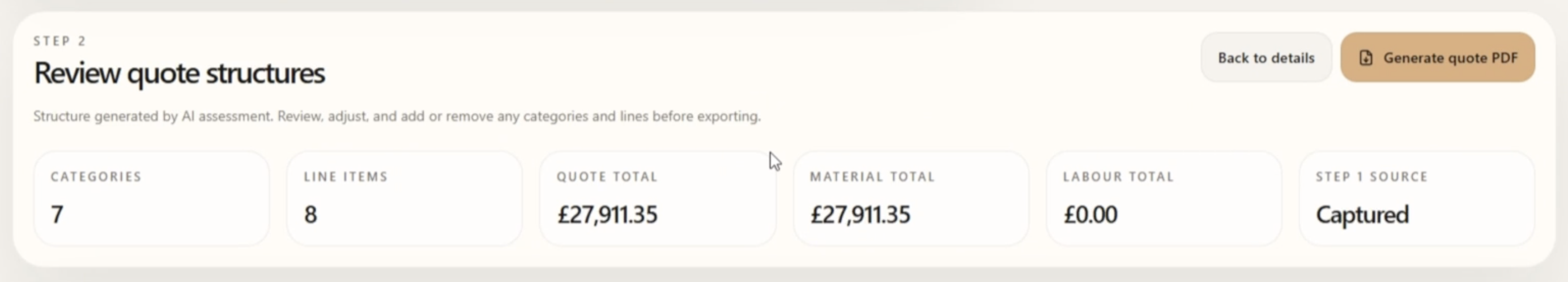

How Quotify helps

Quotify is built for this exact first-pass stage. It turns drawings, specifications, photos and scope notes into a builder-reviewed quote pack, with labour, materials, plant, subcontractors, prelims, assumptions, risks and missing information separated before the final number is sent.

The builder still controls the final price. Quotify helps make the working visible quickly enough to review it before the quote becomes a commitment.

Have a project pack that is not complete yet?

Send the drawings, specs or notes you have. Quotify will review whether the project is a strong fit and show how the quote pack could be structured before you send the fixed-price number.
